Space Elevator Design Verification

by Peter Robinson

Article 6: Final Verification Before Earth Space Elevator Deployment

1. Introduction

This is my final article discussing the Verification of Earth Space Elevator Designs, essential before deployment of the full-scale system. Robust verification also may be needed for regulatory permissions and to counter poorly informed technical and non-technical objections.

My first article introduced project management methodologies and their application to the SE mega-project [1] [2], followed by second and third articles covering ground testing of SE sub-system designs [3] [4]. The next two articles covered “Pathfinder” orbital space tests [5] [6].

To address the matter from a project management perspective I considered the requirements of the Technology Readiness Level system (TRL, as used by NASA and others), summarised in Figure 1 below.

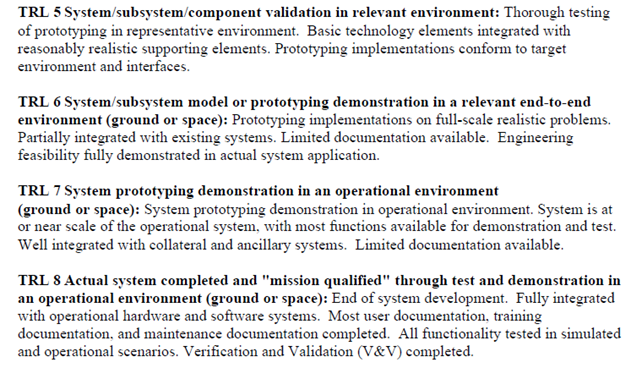

Figure 1: TRL Definition Summary. Credit: NASA.

The orbital tests described in my previous articles [5] [6] certainly address the requirements of TRL-5, and perhaps TRL-6, being “testing of prototyping in a representative environment”.

ISEC publications in 2014 [7] and 2017 [8] have suggested that ground tests and the “Pathfinder” work will also be sufficient to prepare for final system deployment, meaning that TRL-7 requirements are satisfied. These requirements may have been met by some SE sub-systems (such as climber components in common with existing spacecraft), but many Space Elevator components are totally novel and so need more thorough proving. In particular the TRL-7 requirement “at or near the scale of (the) operational system” must be addressed.

Section 2 below describes what further work might be needed to complete the Verification of the three key SE sub-systems “Tether”, “Climber”, and “Dynamics” (defined in Ref [2] Section 4).

2. Design Verification Phase 5: Sub-Systems

I outlined my thoughts on this in a presentation in 2018 at the IAC conference in Bremen [9] based on my simple literal interpretation of the TRL words. Figures 2 and 3 below reproduce my slides suggesting Asteroid Elevators to meet TRL-6.

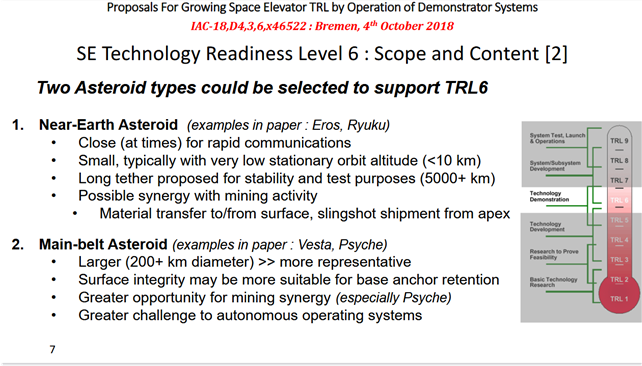

Figure 2: “Scope and Work Content for TRL-6 [1]”, from IAC-2018 Presentation by P. Robinson.

Figure 3: “Scope and Work Content for TRL-6 [2]”, from IAC-2018 Presentation by P. Robinson.

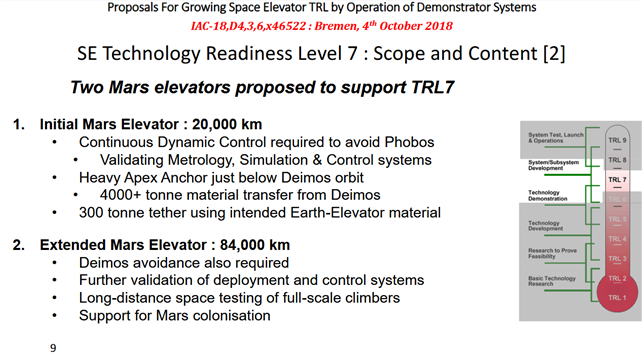

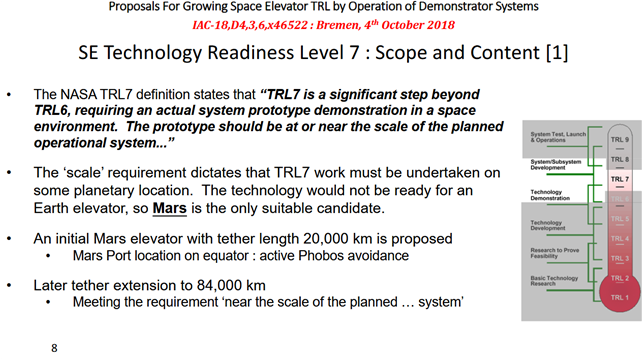

I then proposed a Mars Elevator to address the TRL-7 requirement for a larger-scale final test article, as shown in Figures 4 and 5 below.

Figure 4: “Scope and Work Content for TRL-7 [1]”, from IAC-2018 Presentation by P. Robinson.

Figure 5: “Scope and Work Content for TRL-7 [1]”, from IAC-2018 Presentation by P. Robinson.

My general arguments for these two work phases are included in the IAC-2018 conference paper; see ref [9]: I will not repeat those words here, but I will review how Asteroid and Mars Elevator tests might address the Verification of the three SE sub-systems.

Note: I discussed concepts for both Asteroid and Mars Elevators in ISEC newsletters in 2024 [10] [11].

2.1 Tether Material

It could be argued that tether material verification would not significantly be moved forward by asteroid testing, and the benefits from Mars testing are also limited. Neither location would precisely match the space environment up to 100,000km Earth altitude, this aspect being better addressed by continued “Pathfinder” orbital testing. Tether degradation from passing climbers might be better explored from ground-based testing involving many more “climber” interactions with greater load factors.

2.2 Climbers

Elevator Climbers will incorporate many separate sub-systems as described in [2], the basic functionality of which will have been thoroughly tested in earlier ground-based and “Pathfinder” space testing.

Towards the end of the Verification process one of the most important requirements will be robust demonstration of overall climber reliability. When Elevator operations commence, many hundreds of climbers will be manufactured each year, and each must have a high probability of travelling the 35,700+ km from the Earth Port to (at least) the GEO node. This means each climber must have a Mean-Time-Before-Failure (MTBF) far in excess of that distance, perhaps of the order of one million km (depending on what failure rate can be tolerated).

Commercial practices for demonstration of MTBF involve the complex field of Reliability Engineering that I will not explore in detail here, but very simply the process involves running many prototypes in representative operational conditions and recording all failures (minor or serious). An MTBF figure is calculated based on the number of prototypes being tested and their time or distance of operation at each failure. In the early stages of a Reliability Growth project phase the calculated MTBF will be very low, but this figure should increase as more prototypes are tested and their accumulated “mileage” increases.

For the Space Elevator project, a decision must be made as to whether ground-based testing could be used to grow the MTBF, but I suspect that this may not be valid from a Reliability Engineering perspective. Extensive climber operation in space may well be needed, and the “Pathfinder” tethers as described earlier [5] [6] [7] [8] are simply too short to allow enough long-distance climbing. Longer and more numerous “Pathfinder” orbital tethers could be an option, but the potential greater length of Asteroid and Mars Elevators might be a better choice.

The need for climber reliability is another argument for having smaller climber modules rather than single larger climbers, for example a 20-tonne (gross) climber could be an assembly of (say) five 4-tonne climber modules. More of the smaller prototype modules could be tested, and each might only require a lower MTBF value if non-catastrophic failure of single modules before GEO could be accepted.

2.3 Dynamics

As described before, the primary “Dynamics” sub-systems (Metrology, Simulation, Control, and RIRO) cannot be demonstrated at the necessary scale using ground-based testing, and the orbital “Pathfinder” tethers are very different from a long tether attached to a rotating massive body such as an Asteroid or Mars.

2.3.1 Metrology

The Metrology sub-system is one aspect of “Dynamics” that might be adequately verified during the “Pathfinder” missions, being in the correct near-Earth environment and so able to make use of GPS and other location systems in Earth orbit.

2.3.2 Simulation

The Simulation sub-system in isolation might be adequately verified before or during the Earth orbit test stage, being primarily a software system and therefore potentially testable in a virtual environment.

That said, the integration of the simulation system with the Metrology and Control sub-systems cannot be fully assessed virtually. In particular, the linkage to the Control system is critical.

2.3.3 Control

Control is the critical aspect of the whole Dynamics sub-system, and at present is perhaps the least explored in detail. My previous article [6] mentioned a student software architecture concept of an “Orbital Brain”, a complex AI-driven system constantly updated by Metrology measurements, orbital situational data, and operational requirements, with real-time simulation exploring and finding the optimum control outputs.

The future task of the Control system is becoming more complex with the rapidly growing number of LEO satellite swarms such as Starlink, and in the near future orbital data centres and massive Space-Based Solar Power (SBSP) stations. (If these future systems were placed at GEO they would have a negligible impact, but present plans are suggesting lower orbits.) These will all increase the workload of the Control System, demanding greater tether positional control accuracy.

Verification of such a complex and critical system must be thorough and incontrovertible, yielding adequate confidence before deployment of even a lightweight “seed” Earth Elevator. I do not consider that this could be achieved based solely on shorter orbital “Pathfinder” tethers; there will be a good case for extensive testing on asteroids and/or Mars, but this must be a decision for the project leadership at a later stage of the project.

2.3.4 RIRO Mechanisms

A Reel-In-Reel-Out (RIRO) mechanism is the one mechanical sub-system that I have placed in the “Dynamics” category. There will need to be a RIRO system at the Earth Port for tension control as climbers are loaded and launched, and for other reasons, but this can be verified by ground-based testing.

Future simulation and operational analysis will determine if a RIRO system is needed at the Apex Anchor, but this design cannot be verified easily. Any Apex RIRO (and power supply) must operate in a low-gravity vacuum environment whilst winching many km of tether under considerable tension (perhaps hundreds tonne-f). These conditions could not be exactly duplicated on the Earth, or during “Pathfinder” orbital tests with just a 1000km tether: a rapidly-rotating asteroid might be the best location to fully replicate Earth Apex conditions for final verification. (The rotation rate of Mars dictates a far longer tether.)

3. Summary

The initial stages of the Space Elevator mega-project will depend on the invention of a suitable tether material and the development of the machines for high-quantity, high-quality manufacture. As the project proceeds, the system concepts and designs may diverge from those of today and impact the accuracy of my attempts to predict the verification process.

My thoughts on the final project stages before full-scale Earth Elevator deployment are therefore speculative, but I hope my ideas on final verification using Asteroid and/or Mars Elevators are of some interest. The tether material will always be a critical part of the system, but I believe that control system demonstration will become equally important before tether deployment can be considered. After deployment the emphasis will shift to operations, relying on continuous dynamics control and the durability & reliability of the climbers themselves.

4. REFERENCES

[1] Technology Readiness Levels - NASA

[2] Peter Robinson: September-2025 ISEC Newsletter Article, “Introduction, Technology Readiness and Design Verification”

[3] Peter Robinson: November-2025 ISEC Newsletter Article, “Part 2: The Start of Design Verification Testing”

[4] Peter Robinson: December-2025 ISEC Newsletter Article, “Part 3: Verification Testing to Prepare for Space”

[5] Peter Robinson: February-2026 ISEC Newsletter, “Article 4: “Pathfinder”, the Start of Verification Testing in Space, Part 1”

[6] Peter Robinson: March-2026 ISEC Newsletter, “Article 5: The Start of Verification Testing in Space, “Pathfinder”, Part 2”

[7] Fitzgerald, Penny, Swan & Swan: “ISEC Position Paper #2014-1 “Space Elevator Architecture and Roadmaps””

[8] Michael “Fitzer” Fitzgerald: Architecture Notes #6 (February 2017)

[9] Peter Robinson: Presentation at October-2018 IAC conference, Bremen (IAC-18-D4.3,6,x46522): “Proposals For Growing Space Elevator TRL by Operation of Demonstrator Systems”. (Paper: IAF copyright, not available on any public website, available to ISEC members in Zotero library)

[10] Peter Robinson: June- & July-2024 ISEC Newsletters, “Part 2a: ASTEROIDS (AND CERES)”, “Part 2b: ASTEROIDS – CONCLUSION”

[11] Peter Robinson: September- & October-2024 ISEC Newsletters, “Part 4a: Mars – Introduction”, “Part 4: Mars (2)”
